PROJECT OVERVIEW:
NAME OF PROJECT | OUTPUT 2: Reconstruction and Development Plan for a Greater Marawi – Stage 2 | ||
Value (LOAN) |
| Original (USD) | Original (PhP) |
ADB | 100.00 M | 5,712 M | |
GOP | 17.65 M | 1,123 M | |
TOTAL | 117.65 M | 6,835 M | |
Loan No. | EAL-ADB Loan No. 3769-PHI | ||
Date of NEDA Board Approval | December 13, 2018 | ||
Date of Signing | December 17, 2018 | ||
Date of Effectiveness | December 27, 2018 | ||
Loan Validity | June 30, 2024 (Original) December 31, 2027 (Revised) | ||
Implementation Schedule | February 2020–September 2022 (Original) February 2020-June 2027 (Revised) | ||
Remarks | For 57 months extension of the implementation duration and 42 months loan validity |
PROJECT DESCRIPTION:

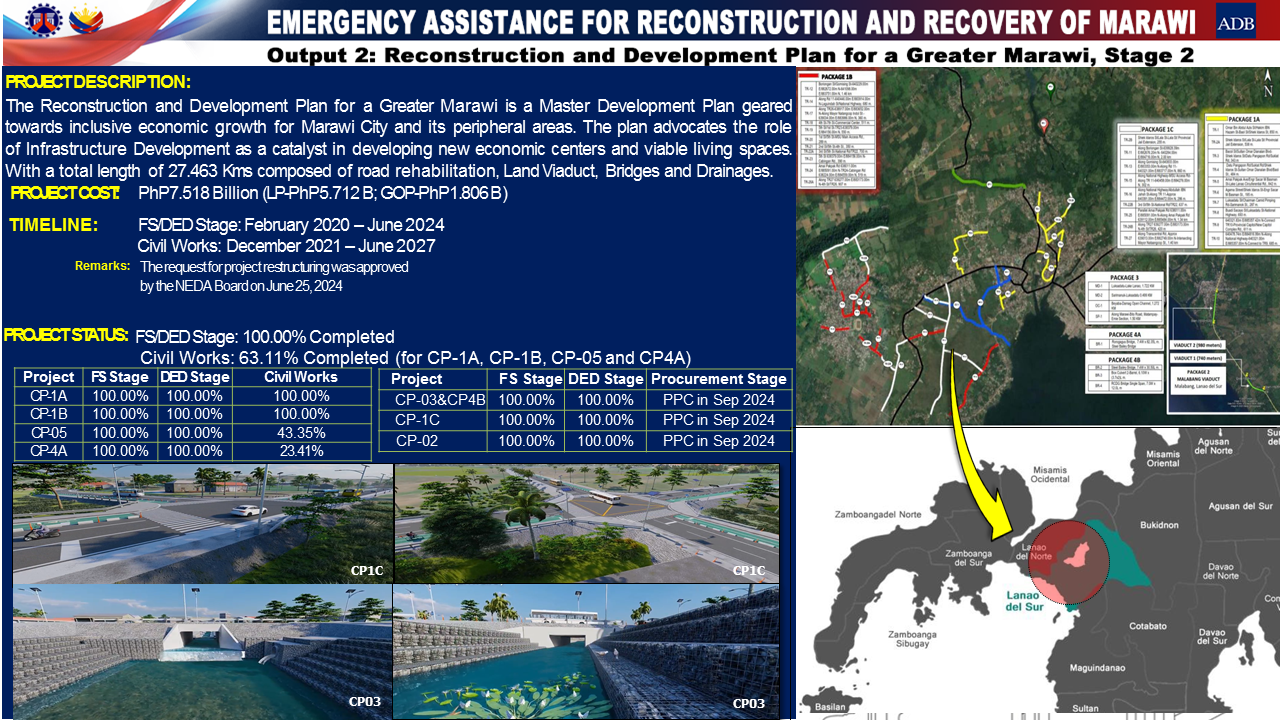

Ø The Reconstruction and Development Plan for a Greater Marawi is a Master Development Plan geared towards inclusive economic growth for Marawi City and its peripheral areas. The plan advocates the role of infrastructure Development as a catalyst in developing new economic centers and viable living spaces.
Components of the project:
· Transcentral Road Phase IV (16.82km)
· Construction of Malabang Viaduct
· Construction of four (4) Bridges
· Construction of Main Drainages, Open Channels and two (2) Connecting Bridges
· Slope Protection Works
PROJECT IMPACT:
Ø Provide a viable solution in fully utilizing the capability of various infrastructure projects to serve as catalysts in building back a better Marawi.
Ø The project envisions to spark development in the peripheral areas referencing from Marawi City centered in the ideas of connectivity and community building. This shall be made evident through the improvement in the social, institutional and economic development sectors of the project areas.
| Road Name | NetLength (km) | Contractor | Contract Amount Million PHP | Implementation Period | Progress |

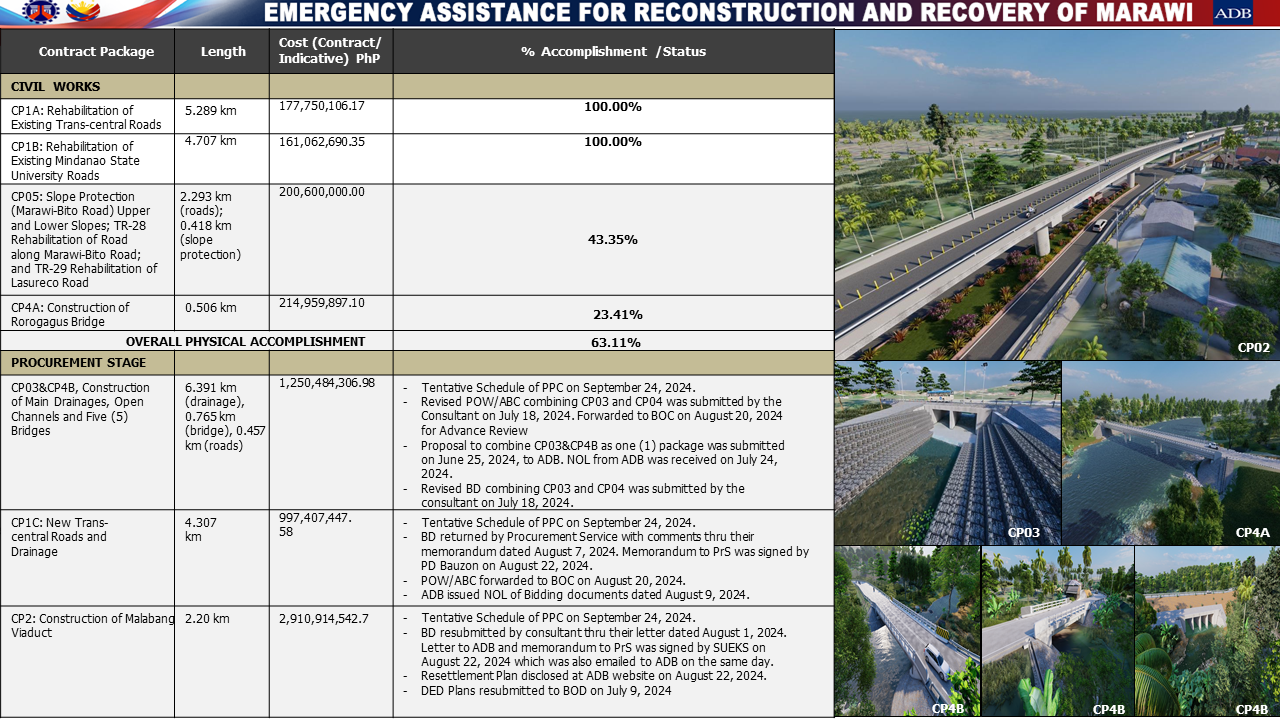

CIVIL WORKS | ||||||

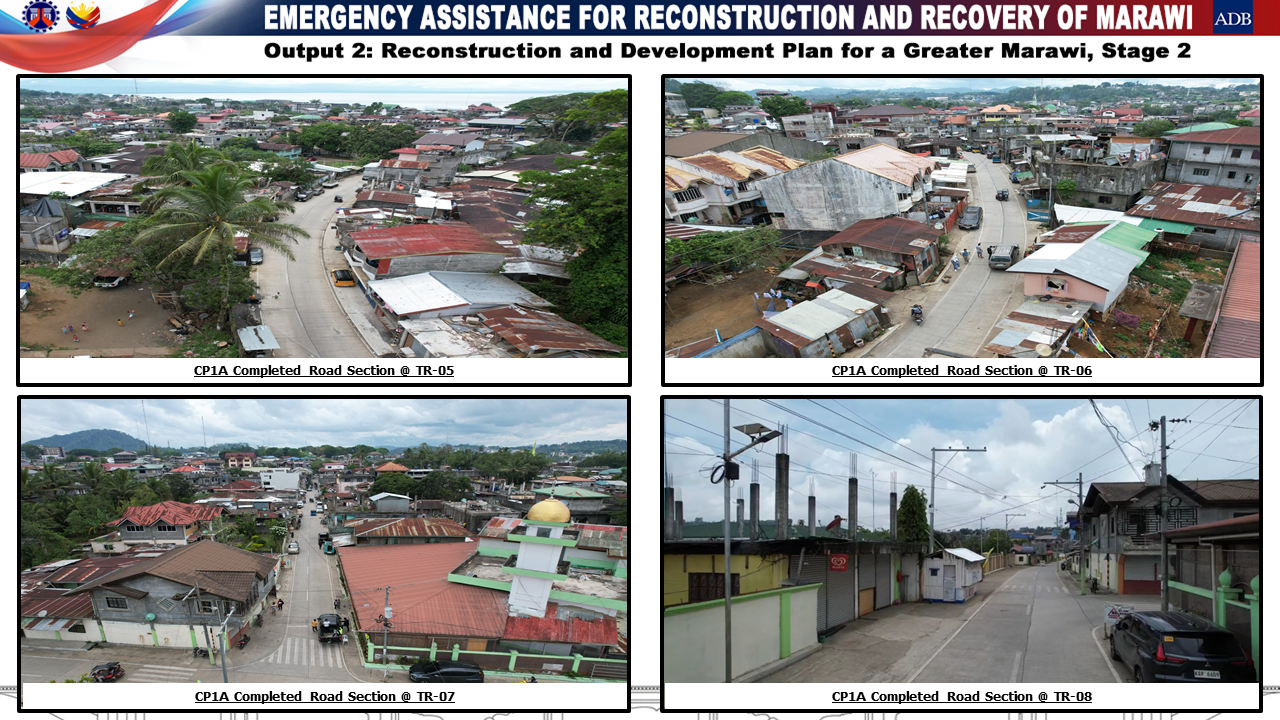

CP1A | Rehabilitation of Existing Trans-central Roads | 5.29 km | Fiat Construction Services | 177.75 | Dec 10, 2021 – Dec 24, 2023 | 89.51% |

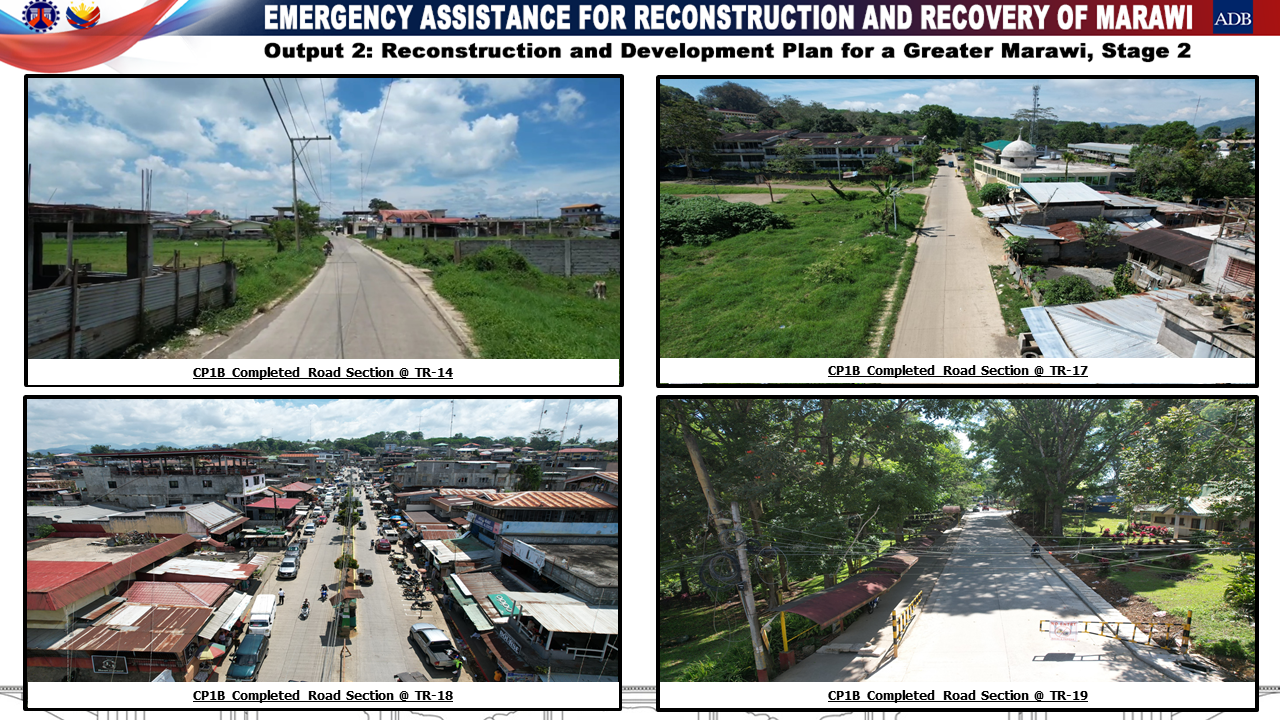

CP1B | Rehabilitation of Existing Mindanao State University Roads | 4.71 km | Kouzbary Builders | 161.06 | Dec 15, 2021 – Dec 30, 2023 | 89.40% |
CP5 | Slope Protection (Marawi-Bito Road) Upper and Lower Slopes; TR-28 Rehabilitation of Road along Marawi-Bito Road; and TR-29 Rehabilitation of Lasureco Road | 2.51 km (roads), 1.30 km (slope protection)
| Kouzbary Builders/MMA Achiever Construction Development Corporation (JV)
| 200.60 | Aug 22, 2023 – Sept 20, 2024 | 13.68% |
CP4A | Construction of Rorogagus Bridge | 0.51 km | - | 214.96 | Jan 2024 – Feb 2025 | Perfection of Contract is on process/approval. |
PROCUREMENT STAGE | ||||||
CP4B | Construction of Cabasaran Bridge, Box Culvert (Guimba Bridge) and Kormatan Matampay Bridge | 0.66 km | - | 205.30 | Feb 2024 – Jul 2024 | For Procurement |
CP1C | New Trans-central Roads and Drainage | 4.31 km | - | 812.57 | Feb 2024 – Jul 2024 | For Procurement |
DED STAGE | ||||||
CP2 | Construction of Malabang Viaduct | 2.20 km | - | 2,134.84 | Mar 2024 – Aug 2024 | 94.00% DED Completed |
CP3 | Construction of Main Drainage Channels | 6.212 km (drainage), 0.09 km (bridge), 0.392 (roads) | - | 1,153.66 | Mar 2024 – Aug 2024 | 95.00% DED Completed |
