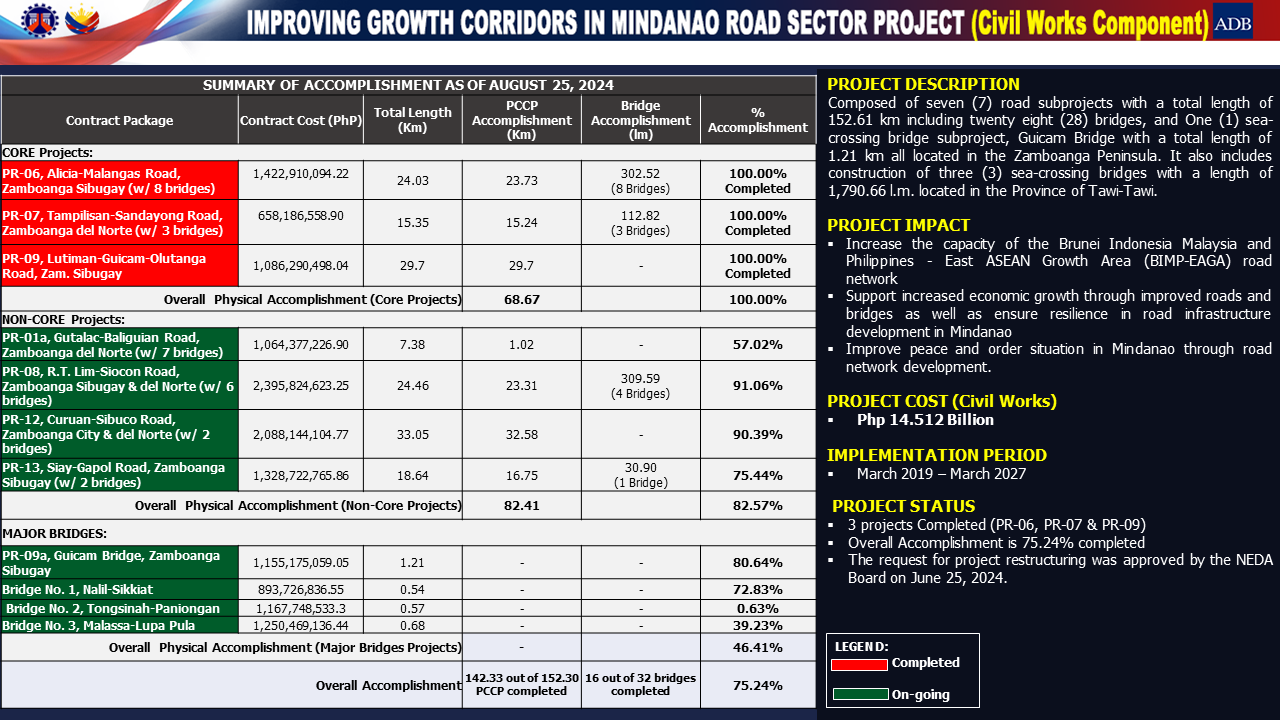

CORE PROJECTS
(As of August 25, 2024)
No. | Road Name | NetLength (km) [Road (km) & Bridge (m)] | Contractor | Contract Amount Million PHP | Implementation Period | Progress |
PR-06 | Alicia-Malangas Road Province, Zamboanga Sibugay | 24.03 km [23.73 km (Road) & 302.52 m (8 Bridges)] | China Geo-Engineering Corporation/ESR Construction and Development Corporation (J/V) | 1,422.91 | Mar 28, 2019 - July 19, 2022 | 100.00% |
PR-07 | Tampilisan - Sandayong Road Province, Zamboanga del Norte | 15.35 km [15.24 km (Road) & 112.82 m (3 Bridges)] | MAC Builders/Fiat Construction Services (JV) | 658.19 | Mar 28, 2019 – Feb 28, 2023 | 100.00% |
PR-09 | Lutiman – Guicam – Olutanga Road Province, Zamboanga Sibugay | 29.70 km [29.70 km (Road) & 0.00 m] | Sino Road and Bridge Group Co., Ltd./M. Abubakar Construction and Engineering, Inc. (JV) | 1,086.29 | Mar 28, 2019 – June 04, 2023 | 100.00% |
Total | 69.08 km [68.67 km & 415.34 m] |
| 3,167.39 |
| 100.00% |
NON-CORE PROJECT
(As of August 25, 2024)
No. | Road Name | NetLength (km) [Road (km) & Bridge (m)] | Contractor | Contract Amount Million PHP | Implementation Period | Progress |
PR-01a | Gutalac-Baliguan Alternative Road, Zamboanga del Norte | 7.38km [7.08km (Road) & 301.5m (7 Bridges)] | China Wuyi Co., Ltd. | 1,064.38 | July 21, 2022 – Nov 13, 2025 |
57.02% |
PR-08 | RT Lim-Siocon Road, Zamboanga Sibugay & del Norte | 24.46km [24.03km (Road) & 430.11 m (6 Bridges)] | China Wuyi Co. Ltd. | 2,395.82 | Feb 26, 2021 – Sept 25, 2024 |
91.06%
|
PR-12 | Curuan-Sibuco Road, Zamboanga City & del Norte | 33.05km [32.98km (Road) & 71.8m (2 Bridges)] | M. Abubakar Construction and Engineering, Inc./ Sino Road and Bridge Group Co. Ltd. (J/V) | 2,088.14 | Mar 15, 2021 – Mar 09, 2025 |
90.39%
|
PR-13 | Siay-Gapol Road, Zamboanga Sibugay | 18.64km [18.32km (Road) & 311.8m (2 Bridges)] | Qingdao Municipal Construction Group Co., Ltd/ESR Construction and Development Corporation (J/V) | 1,328.72 | Jan 28, 2021 – Dec 15, 2024 |
75.44% |
Total |
| 83.53km [82.41km & 1115.21m] |
| 6,877.06 |
| 82.57% |
MAJOR BRIDGE PROJECTS
(As of August 25, 2024)
No. | Road Name | NetLength (m) [Road (m) & Bridge (m)] | Contractor | Contract Amount Million PHP | Implementation Period | Progress
|
PR-09a | Guicam Bridge, Zamboanga Sibugay | 1.21km [0.67km (Road) & 540.80m (1 Bridges] | Tianyuan Construction Group Corporation/ Grace Construction Corporation (JV) | 1,155.18 | Jan 29, 2021 – Dec 30, 2024 |
80.64% |
Br.1 | Nalil-Sikkiat Bridge, Tawi-Tawi | 0.541km [160m & 380.80m] | China Wuyi Co., Ltd. | 893.73 | July 21, 2022 – July 20, 2025 | 72.83% |
Br. 2 | Tongsinah-Paniongan, Tawi-Tawi | 0.569km [188.46m & 380.80m] | China Wuyi Co., Ltd. / Vicente T. Lao Construction (Consortium) | 1,167.75 | August 14, 2024 – August 14, 2027 | 0.63% |
Br.3 | Malassa-Lupa Pula Bridge, Tawi-tawi | 0.681km [200m & 480.60m] | Vicente T. Lao Construction / China Wuyi Co., Ltd. (Consortium) | 1,250.47 | July 21, 2022 – Sept 18, 2025 |
39.23% |
Total |
| 3.001km [1219.13m & 1783.00m] |
| 4,467.12 |
| 46.41% |
